Deck 18: Project Management

Full screen (f)
exit full mode
Question
A slack of (-2) means the project is ahead of schedule by two time periods.
Use Space or
up arrow
down arrow
to flip the card.
Question
Project management objectives revolved around on-time and budget performance.
Question
In most organizations, projects cut across organizational boundaries, making it difficult to implement projects exclusively within functional departments.
Question
The Critical Path Method (CPM) allows for an evaluation of uncertainty in project completion times.
Question
Activity times must be estimated from historical data of similar work tasks to provide realism for a project.
Question
The early start time for an activity is computed by finding the largest early finish time of all immediate predecessors.
Question
Immediate predecessors are activities that must be completed immediately before an activity may start.
Question
Project managers need to be specialists, not generalists.
Question
When the beta probability distribution is used to characterize uncertain activity times, the distribution of the project completion time will also have a beta probability distribution.
Question
To compute the critical path, we assign all nodes in the network an earliest starting time of zero.
Question
A Gantt chart is a useful tool for allocating limited resources among project activities.
Question
Strong leadership is an impediment to project management success because of the team-based nature of most projects.
Question
With the Activity-On-Node (AON) network, the nodes define the precedence relationships and the arcs define the work activities.
Question
All activities on the critical path have a zero slack time.
Question
In a matrix organization, functional managers may be reluctant to provide the resources and employees, and the employees assigned to projects may relegate a project to a lower priority than their daily functional job.
Question
The critical path is the sequence of activities that takes the longest time.
Question
A statement of work would be developed in the "Organize" step of the project life cycle.
Question
Crashing refers to the process of shortening selected activity times in order to reduce the overall project completion time.
Question
Because the preparation of annual reports is done on a repeating basis, project management techniques are not appropriate.
Question
Using a beta probability distribution to characterize uncertain activity times is practical because it allows managers to use judgmental estimates to identify the distribution.
Question
In which stage in the project life cycle would crashing likely be performed?

A)Define
B)Plan
C)Organize
D)Control
Question
Which of the following is not an assumption of the critical path method?

A)Activities are independent of one another
B)Activity time estimates are stable
C)Activity times are characterized by a beta probability distribution
D)Once an activity is started it continues uninterrupted until completion
Question
We should not crash activities on the critical path.
Question
Which of the following is incorrect regarding time/cost trade-offs?

A)The relationship between time and cost is proportional
B)Some activities cannot be crashed
C)The minimum cost can be found by crashing all activities as much as possible
D)Crashing priority is based on the amount of uncertainty in activity times
Question
Which of the following is not a stage in the project life cycle?

A)Define
B)Organize
C)Improve
D)Close
Question
Which statement is true regarding activities not on the critical path?

A)Usually cannot be delayed
B)Have less slack than activities on the critical path
C)Can delay a project if they are highly variable
D)Are used to crash project completion times
Question

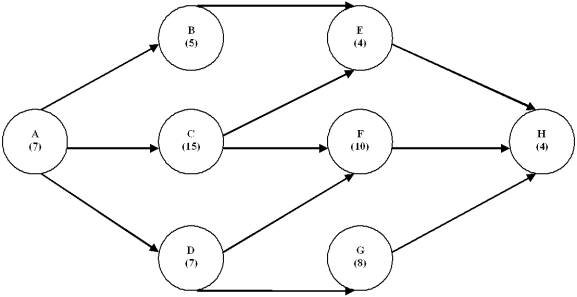

The county government has decided to redo the street you live on and plans to block the street off which causes you and your neighbor's considerable inconvenience.The project has three parallel paths defined as follows: (i) path A-B-C-H to install street lights and electrical wiring that takes 16 days, (ii) path A-D-E-H to install sidewalks with handicap capabilities that takes 22 days, and (iii) path A-F-G-H to repave the street including storm drains that takes 30 days.Which one of the following statements is true?

A)The expected duration of the project is 30 + 22 + 16 = 68 days.
B)Path A-B-C-H is the critical path.
C)Path A-D-E-H has the most slack time.
D)Path A-F-G-H is the critical path.
Question
Which of the following is not considered a project?

A)Writing and implementing a computer program
B)Introducing a new product
C)Production of soft drinks
D)Building a bridge
Question
A project has three paths.A-B-C has a length of 25 days.A-D-C has a length of 15 days.Finally, A-E-C has a length of 20 days.Which one of the following statements is true?

A)A-D-C is the critical path.
B)A-B-C has the most slack.
C)The expected duration of this project is 25 days.
D)The expected duration of this project is 25 + 15 + 20 = 60 days.
Question
A type of organization that can result in inefficiencies because of duplication of resources across the organization is called

A)Pure project structure
B)Pure functional structure
C)Matrix structure
D)Product structure
Question
Which step in the project management process would involve developing alternative plans in anticipation of problems that might arise?

A)Project definition
B)Resource planning
C)Project scheduling
D)Project control
Question
The slack for an activity is equal to its latest finish time minus its earliest start time.
Question
In which stage in the project life cycle would a Gantt chart be used?

A)Define
B)Plan
C)Organize
D)Control
Question
In which stage in the project life cycle would critical path calculations be performed?

A)Define
B)Plan
C)Organize
D)Control
Question
Which step in the project management process would involve determining time estimates for activities?

A)Project definition
B)Resource planning
C)Project scheduling
D)Project control
Question
Slack in an activity is computed as

A)ES - LS
B)EF - LF
C)LS - ES
D)LS - EF
Question
When finding the earliest finish (EF) time for an activity with two or more predecessor activities, the largest EF among the predecessor activities is used to calculate the EF for that activity.
Question
Which of the following is least related to Program Evaluation and Review Technique (PERT)?

A)Beta distribution
B)Variance
C)Most probable time
D)Crashing
Question
A type of organization which "loans" resources to projects while still maintaining control over them is called

A)Pure project structure
B)Pure functional structure
C)Matrix structure
D)Product structure
Question
Which is incorrect regarding the critical path?

A)Shortest time to complete a project
B)Longest time to complete a project
C)Project path with 0 slack
D)Delays in activities will delay the project
Question
Explain the role of the project managers and some principles for success.
Question
Explain the purpose of Gantt charts.
Question
Data regarding the activities for a project are presented below.The times are in weeks.The critical path for this project is A - D - H - I - J - K.
Data regarding the activities for a project are presented below.The times are in weeks.The critical path for this project is A - D - H - I - J - K.   a.Determine the standard deviation of the critical path. b.Determine the probability of completing the project in 38 weeks or less. c.What is the probability of completing the project in 32 weeks or less?<div style=padding-top: 35px>
a.Determine the standard deviation of the critical path.
b.Determine the probability of completing the project in 38 weeks or less.
c.What is the probability of completing the project in 32 weeks or less?
Question
Describe the four major steps in the project-planning process.
Question

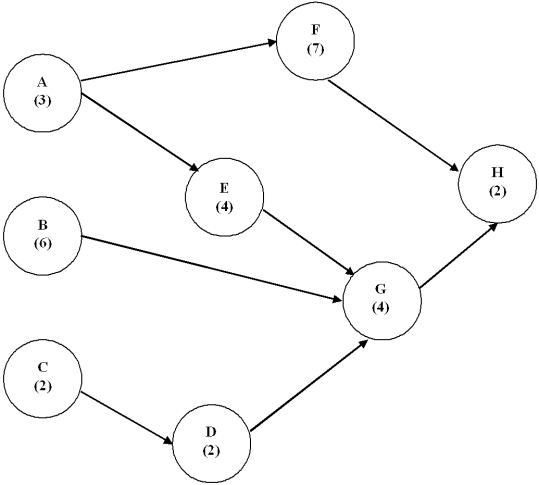

The following network shows all the major activities on the circles (nodes).Each node contains time estimates in weeks. The following network shows all the major activities on the circles (nodes).Each node contains time estimates in weeks.   Complete the following table.  <div style=padding-top: 35px> Complete the following table. The following network shows all the major activities on the circles (nodes).Each node contains time estimates in weeks.   Complete the following table.  <div style=padding-top: 35px>
Question
Consider the project network and data shown below: Consider the project network and data shown below:     a.Determine the critical path. b.If management wants the project done in one less month, which activity should they crash?<div style=padding-top: 35px> Consider the project network and data shown below:     a.Determine the critical path. b.If management wants the project done in one less month, which activity should they crash?<div style=padding-top: 35px>
a.Determine the critical path.
b.If management wants the project done in one less month, which activity should they crash?
Question
Define a project.Give some non-manufacturing or non-construction examples.
Question
Explain the three time estimates used to characterize uncertainty of activity times in the Program Evaluation and Review Technique (PERT) procedure.
Question
A manufacturing company is planning to use PERT to setup a project for a new production line.For this project, they have established the following activities, precedence relationships, and time estimates in days:
A manufacturing company is planning to use PERT to setup a project for a new production line.For this project, they have established the following activities, precedence relationships, and time estimates in days:   a.What is the expected duration for activity b? b.What is the variance of activity d? c.How many paths are there in the network? d.What is the earliest finish (EF) time for activity e? e.What is the slack in days for activity c? f.What is the critical path? g.What is the duration of the critical path in days? h.What is the standard deviation of the critical path? i.What is the probability of completing the project within 50 days?<div style=padding-top: 35px>
a.What is the expected duration for activity b?
b.What is the variance of activity d?
c.How many paths are there in the network?
d.What is the earliest finish (EF) time for activity e?
e.What is the slack in days for activity c?
f.What is the critical path?
g.What is the duration of the critical path in days?
h.What is the standard deviation of the critical path?
i.What is the probability of completing the project within 50 days?
Question
Describe how a project fits into each of the three common organizational structures.
Question
List at least six principal factors (contributors) to project success.
Question
Explain the stages of the project life cycle.
Question
Define critical path and explain how it is identified once a project schedule is calculated
Question

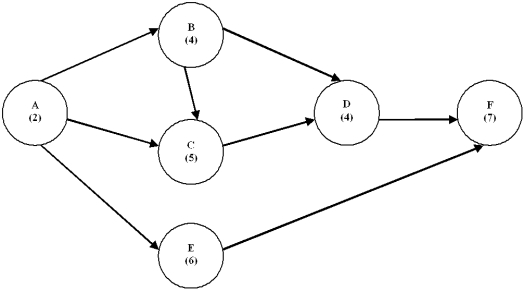

A company wants to develop a project using PERT to modify one of their products which has poor sales.They have determined the following activities, precedence relationships and time estimates in days for the project:
A company wants to develop a project using PERT to modify one of their products which has poor sales.They have determined the following activities, precedence relationships and time estimates in days for the project:   a.What is the expected duration for activity a? b.What is the variance for activity d? c.How many paths are there in the network? d.What is the earliest start (ES) time for activity e? e.What is the slack in days for activity b? f.What is the critical path? g.What is the duration of the critical path in days? h.What is the standard deviation of the critical path? i.What is the probability that the project will take longer than 28 weeks to complete?<div style=padding-top: 35px> a.What is the expected duration for activity a?
b.What is the variance for activity d?
c.How many paths are there in the network?
d.What is the earliest start (ES) time for activity e?
e.What is the slack in days for activity b?
f.What is the critical path?
g.What is the duration of the critical path in days?
h.What is the standard deviation of the critical path?
i.What is the probability that the project will take longer than 28 weeks to complete?
Question
A company has a PERT project with path b-d-e-g-i that has these activity time estimates in days:
A company has a PERT project with path b-d-e-g-i that has these activity time estimates in days:   a.What is the expected duration for activity e? b.What is the variance for activity b? c.What is the standard deviation of the path?<div style=padding-top: 35px>
a.What is the expected duration for activity "e"?
b.What is the variance for activity "b"?
c.What is the standard deviation of the path?
Question
Consider the project network and data shown below: Consider the project network and data shown below:     a.Determine the critical path and the project completion time. b.Determine the crash cost per week for all activities c.Which activities need to be crashed to reduce the project's completion time by 4 weeks? How much does this cost?<div style=padding-top: 35px> Consider the project network and data shown below:     a.Determine the critical path and the project completion time. b.Determine the crash cost per week for all activities c.Which activities need to be crashed to reduce the project's completion time by 4 weeks? How much does this cost?<div style=padding-top: 35px>
a.Determine the critical path and the project completion time.
b.Determine the crash cost per week for all activities
c.Which activities need to be crashed to reduce the project's completion time by 4 weeks? How much does this cost?
Question
The network below represents a project being analyzed by the Critical Path Method. The network below represents a project being analyzed by the Critical Path Method.   a.What activity must be on the critical path, regardless of activity durations? b.What is the duration of path A-B-E-H-J? c.What is the critical path of this network? d.What is the length of the critical path?<div style=padding-top: 35px>
a.What activity must be on the critical path, regardless of activity durations?
b.What is the duration of path A-B-E-H-J?
c.What is the critical path of this network?
d.What is the length of the critical path?
Question

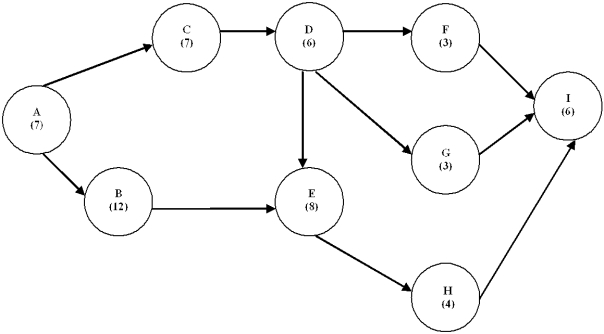

A company has developed a project using CPM but is interested in accelerating it if possible.The project has the following activities, durations (in weeks), costs, and precedence relationships:
A company has developed a project using CPM but is interested in accelerating it if possible.The project has the following activities, durations (in weeks), costs, and precedence relationships:   a.How many paths are in the network? b.What is the earliest finish (EF) time for activity f? c.What is the slack in weeks for activity c? d.What is the critical path? e.What is the duration of the critical path in weeks? f.What activity should be crashed first to accelerate the project? g.What is the final duration of the fully crashed project? h.What is the total crashing cost for the project?<div style=padding-top: 35px>
a.How many paths are in the network?
b.What is the earliest finish (EF) time for activity f?
c.What is the slack in weeks for activity "c"?
d.What is the critical path?
e.What is the duration of the critical path in weeks?
f.What activity should be crashed first to accelerate the project?
g.What is the final duration of the fully crashed project?
h.What is the total crashing cost for the project?
Question
A company has used PERT for a project and wants to minimize the probability of overrunning a contract deadline of 30 weeks.Three paths of concern in the PERT network have these mean durations and variances in weeks:
A company has used PERT for a project and wants to minimize the probability of overrunning a contract deadline of 30 weeks.Three paths of concern in the PERT network have these mean durations and variances in weeks:   a.What is the Z-score for path 1? b.What is the probability of path 2 overrunning the deadline?<div style=padding-top: 35px>
a.What is the Z-score for path 1?
b.What is the probability of path 2 overrunning the deadline?
Question
The following network shows the activities on the circles or nodes.Time estimates are in weeks. The following network shows the activities on the circles or nodes.Time estimates are in weeks.   Complete the following table:  <div style=padding-top: 35px> Complete the following table:
The following network shows the activities on the circles or nodes.Time estimates are in weeks.   Complete the following table:  <div style=padding-top: 35px>
Question
You are in charge of the "advertising program" for the Boston Red Sox baseball team during their spring training in Fort Myers, Florida.You have defined the advertising program as a project with the following characteristics.The goal is to fill all stadium seats during the spring training season.
You are in charge of the advertising program for the Boston Red Sox baseball team during their spring training in Fort Myers, Florida.You have defined the advertising program as a project with the following characteristics.The goal is to fill all stadium seats during the spring training season.   a.What is the earliest completion time for this project? b.What is the largest amount of slack that any activity has in this project? c.If activity C is delayed three weeks, what is the revised earliest project completion time? d.For the original CPM problem, what is the minimum number of activities that would have to be crashed in order to reduce the project's earliest completion time by two weeks assuming all activity crash costs per week are the same and all activities can be crashed?<div style=padding-top: 35px>
a.What is the earliest completion time for this project?
b.What is the largest amount of slack that any activity has in this project?
c.If activity C is delayed three weeks, what is the revised earliest project completion time?
d.For the original CPM problem, what is the minimum number of activities that would have to be crashed in order to reduce the project's earliest completion time by two weeks assuming all activity crash costs per week are the same and all activities can be crashed?
Question

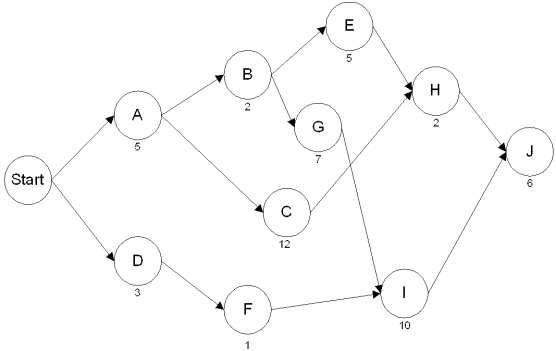

A manufacturing company wants to accelerate a project it has underway for a new product in order to beat their competitors to market.They used CPM to develop the project which has the following activities, durations (in weeks), costs (in dollars), and precedence relationships:
A manufacturing company wants to accelerate a project it has underway for a new product in order to beat their competitors to market.They used CPM to develop the project which has the following activities, durations (in weeks), costs (in dollars), and precedence relationships:   a.How many paths are in the network? b.What is the latest finish (LF) time for activity g? c.What is the slack in weeks for activity c? d.What is the critical path for this project? e.What is the duration of the critical path in weeks? f.What activity should be crashed first in order to accelerate the project? g.What is the final project duration in weeks assuming it is crashed as far as possible? h.What is total cost to crash the project as far as possible?<div style=padding-top: 35px>
a.How many paths are in the network?
b.What is the latest finish (LF) time for activity g?
c.What is the slack in weeks for activity c?
d.What is the critical path for this project?
e.What is the duration of the critical path in weeks?
f.What activity should be crashed first in order to accelerate the project?
g.What is the final project duration in weeks assuming it is crashed as far as possible?
h.What is total cost to crash the project as far as possible?
Question
You are responsible for managing an advertising and promotion project with the following activities (times are given in weeks).
You are responsible for managing an advertising and promotion project with the following activities (times are given in weeks).   a.What is the critical path and expected completion time for this project? b.Which activity has the largest slack, and how large is that slack? c.What is the probability that the project will be completed within 16 weeks? d.If the expected time (not the most likely time) for activity B is changed to 18 weeks from 11 weeks, by how many weeks will the project's expected completion time increase?<div style=padding-top: 35px>
a.What is the critical path and expected completion time for this project?
b.Which activity has the largest slack, and how large is that slack?
c.What is the probability that the project will be completed within 16 weeks?
d.If the expected time (not the most likely time) for activity B is changed to 18 weeks from 11 weeks, by how many weeks will the project's expected completion time increase?
Unlock Deck
Sign up to unlock the cards in this deck!
Unlock Deck
Unlock Deck
1/63
auto play flashcards
Play
simple tutorial
Full screen (f)
exit full mode
Deck 18: Project Management
1
A slack of (-2) means the project is ahead of schedule by two time periods.
False
2
Project management objectives revolved around on-time and budget performance.
True
3
In most organizations, projects cut across organizational boundaries, making it difficult to implement projects exclusively within functional departments.
True
4
The Critical Path Method (CPM) allows for an evaluation of uncertainty in project completion times.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
5
Activity times must be estimated from historical data of similar work tasks to provide realism for a project.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
6
The early start time for an activity is computed by finding the largest early finish time of all immediate predecessors.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
7
Immediate predecessors are activities that must be completed immediately before an activity may start.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
8
Project managers need to be specialists, not generalists.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
9
When the beta probability distribution is used to characterize uncertain activity times, the distribution of the project completion time will also have a beta probability distribution.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
10
To compute the critical path, we assign all nodes in the network an earliest starting time of zero.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
11
A Gantt chart is a useful tool for allocating limited resources among project activities.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
12
Strong leadership is an impediment to project management success because of the team-based nature of most projects.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
13
With the Activity-On-Node (AON) network, the nodes define the precedence relationships and the arcs define the work activities.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
14
All activities on the critical path have a zero slack time.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
15
In a matrix organization, functional managers may be reluctant to provide the resources and employees, and the employees assigned to projects may relegate a project to a lower priority than their daily functional job.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
16
The critical path is the sequence of activities that takes the longest time.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
17
A statement of work would be developed in the "Organize" step of the project life cycle.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
18
Crashing refers to the process of shortening selected activity times in order to reduce the overall project completion time.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
19
Because the preparation of annual reports is done on a repeating basis, project management techniques are not appropriate.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
20
Using a beta probability distribution to characterize uncertain activity times is practical because it allows managers to use judgmental estimates to identify the distribution.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
21
In which stage in the project life cycle would crashing likely be performed?

A)Define
B)Plan
C)Organize
D)Control
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
22
Which of the following is not an assumption of the critical path method?

A)Activities are independent of one another
B)Activity time estimates are stable
C)Activity times are characterized by a beta probability distribution
D)Once an activity is started it continues uninterrupted until completion
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
23
We should not crash activities on the critical path.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
24
Which of the following is incorrect regarding time/cost trade-offs?

A)The relationship between time and cost is proportional
B)Some activities cannot be crashed
C)The minimum cost can be found by crashing all activities as much as possible
D)Crashing priority is based on the amount of uncertainty in activity times
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
25
Which of the following is not a stage in the project life cycle?

A)Define
B)Organize
C)Improve
D)Close
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
26
Which statement is true regarding activities not on the critical path?

A)Usually cannot be delayed
B)Have less slack than activities on the critical path
C)Can delay a project if they are highly variable
D)Are used to crash project completion times
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
27
The county government has decided to redo the street you live on and plans to block the street off which causes you and your neighbor's considerable inconvenience.The project has three parallel paths defined as follows: (i) path A-B-C-H to install street lights and electrical wiring that takes 16 days, (ii) path A-D-E-H to install sidewalks with handicap capabilities that takes 22 days, and (iii) path A-F-G-H to repave the street including storm drains that takes 30 days.Which one of the following statements is true?

A)The expected duration of the project is 30 + 22 + 16 = 68 days.
B)Path A-B-C-H is the critical path.
C)Path A-D-E-H has the most slack time.
D)Path A-F-G-H is the critical path.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
28
Which of the following is not considered a project?

A)Writing and implementing a computer program
B)Introducing a new product
C)Production of soft drinks
D)Building a bridge
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
29
A project has three paths.A-B-C has a length of 25 days.A-D-C has a length of 15 days.Finally, A-E-C has a length of 20 days.Which one of the following statements is true?

A)A-D-C is the critical path.
B)A-B-C has the most slack.
C)The expected duration of this project is 25 days.
D)The expected duration of this project is 25 + 15 + 20 = 60 days.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
30
A type of organization that can result in inefficiencies because of duplication of resources across the organization is called

A)Pure project structure
B)Pure functional structure
C)Matrix structure
D)Product structure
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
31
Which step in the project management process would involve developing alternative plans in anticipation of problems that might arise?

A)Project definition
B)Resource planning
C)Project scheduling
D)Project control
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
32
The slack for an activity is equal to its latest finish time minus its earliest start time.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
33
In which stage in the project life cycle would a Gantt chart be used?

A)Define
B)Plan
C)Organize
D)Control
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
34
In which stage in the project life cycle would critical path calculations be performed?

A)Define
B)Plan
C)Organize
D)Control
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
35
Which step in the project management process would involve determining time estimates for activities?

A)Project definition
B)Resource planning
C)Project scheduling
D)Project control
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
36
Slack in an activity is computed as

A)ES - LS
B)EF - LF
C)LS - ES
D)LS - EF
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
37
When finding the earliest finish (EF) time for an activity with two or more predecessor activities, the largest EF among the predecessor activities is used to calculate the EF for that activity.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
38
Which of the following is least related to Program Evaluation and Review Technique (PERT)?

A)Beta distribution
B)Variance
C)Most probable time
D)Crashing
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
39
A type of organization which "loans" resources to projects while still maintaining control over them is called

A)Pure project structure
B)Pure functional structure
C)Matrix structure
D)Product structure
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
40
Which is incorrect regarding the critical path?

A)Shortest time to complete a project
B)Longest time to complete a project
C)Project path with 0 slack
D)Delays in activities will delay the project
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
41
Explain the role of the project managers and some principles for success.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
42
Explain the purpose of Gantt charts.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
43
Data regarding the activities for a project are presented below.The times are in weeks.The critical path for this project is A - D - H - I - J - K.
Data regarding the activities for a project are presented below.The times are in weeks.The critical path for this project is A - D - H - I - J - K.   a.Determine the standard deviation of the critical path. b.Determine the probability of completing the project in 38 weeks or less. c.What is the probability of completing the project in 32 weeks or less?
a.Determine the standard deviation of the critical path.
b.Determine the probability of completing the project in 38 weeks or less.
c.What is the probability of completing the project in 32 weeks or less?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
44
Describe the four major steps in the project-planning process.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
45
The following network shows all the major activities on the circles (nodes).Each node contains time estimates in weeks. The following network shows all the major activities on the circles (nodes).Each node contains time estimates in weeks.   Complete the following table.  Complete the following table. The following network shows all the major activities on the circles (nodes).Each node contains time estimates in weeks.   Complete the following table.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
46
Consider the project network and data shown below: Consider the project network and data shown below:     a.Determine the critical path. b.If management wants the project done in one less month, which activity should they crash? Consider the project network and data shown below:     a.Determine the critical path. b.If management wants the project done in one less month, which activity should they crash?
a.Determine the critical path.
b.If management wants the project done in one less month, which activity should they crash?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
47
Define a project.Give some non-manufacturing or non-construction examples.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
48
Explain the three time estimates used to characterize uncertainty of activity times in the Program Evaluation and Review Technique (PERT) procedure.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
49
A manufacturing company is planning to use PERT to setup a project for a new production line.For this project, they have established the following activities, precedence relationships, and time estimates in days:
A manufacturing company is planning to use PERT to setup a project for a new production line.For this project, they have established the following activities, precedence relationships, and time estimates in days:   a.What is the expected duration for activity b? b.What is the variance of activity d? c.How many paths are there in the network? d.What is the earliest finish (EF) time for activity e? e.What is the slack in days for activity c? f.What is the critical path? g.What is the duration of the critical path in days? h.What is the standard deviation of the critical path? i.What is the probability of completing the project within 50 days?
a.What is the expected duration for activity b?
b.What is the variance of activity d?
c.How many paths are there in the network?
d.What is the earliest finish (EF) time for activity e?
e.What is the slack in days for activity c?
f.What is the critical path?
g.What is the duration of the critical path in days?
h.What is the standard deviation of the critical path?
i.What is the probability of completing the project within 50 days?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
50
Describe how a project fits into each of the three common organizational structures.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
51
List at least six principal factors (contributors) to project success.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
52
Explain the stages of the project life cycle.
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
53
Define critical path and explain how it is identified once a project schedule is calculated
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
54
A company wants to develop a project using PERT to modify one of their products which has poor sales.They have determined the following activities, precedence relationships and time estimates in days for the project:
A company wants to develop a project using PERT to modify one of their products which has poor sales.They have determined the following activities, precedence relationships and time estimates in days for the project:   a.What is the expected duration for activity a? b.What is the variance for activity d? c.How many paths are there in the network? d.What is the earliest start (ES) time for activity e? e.What is the slack in days for activity b? f.What is the critical path? g.What is the duration of the critical path in days? h.What is the standard deviation of the critical path? i.What is the probability that the project will take longer than 28 weeks to complete? a.What is the expected duration for activity a?
b.What is the variance for activity d?
c.How many paths are there in the network?
d.What is the earliest start (ES) time for activity e?
e.What is the slack in days for activity b?
f.What is the critical path?
g.What is the duration of the critical path in days?
h.What is the standard deviation of the critical path?
i.What is the probability that the project will take longer than 28 weeks to complete?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
55
A company has a PERT project with path b-d-e-g-i that has these activity time estimates in days:
A company has a PERT project with path b-d-e-g-i that has these activity time estimates in days:   a.What is the expected duration for activity e? b.What is the variance for activity b? c.What is the standard deviation of the path?
a.What is the expected duration for activity "e"?
b.What is the variance for activity "b"?
c.What is the standard deviation of the path?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
56
Consider the project network and data shown below: Consider the project network and data shown below:     a.Determine the critical path and the project completion time. b.Determine the crash cost per week for all activities c.Which activities need to be crashed to reduce the project's completion time by 4 weeks? How much does this cost? Consider the project network and data shown below:     a.Determine the critical path and the project completion time. b.Determine the crash cost per week for all activities c.Which activities need to be crashed to reduce the project's completion time by 4 weeks? How much does this cost?
a.Determine the critical path and the project completion time.
b.Determine the crash cost per week for all activities
c.Which activities need to be crashed to reduce the project's completion time by 4 weeks? How much does this cost?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
57
The network below represents a project being analyzed by the Critical Path Method. The network below represents a project being analyzed by the Critical Path Method.   a.What activity must be on the critical path, regardless of activity durations? b.What is the duration of path A-B-E-H-J? c.What is the critical path of this network? d.What is the length of the critical path?
a.What activity must be on the critical path, regardless of activity durations?
b.What is the duration of path A-B-E-H-J?
c.What is the critical path of this network?
d.What is the length of the critical path?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
58
A company has developed a project using CPM but is interested in accelerating it if possible.The project has the following activities, durations (in weeks), costs, and precedence relationships:
A company has developed a project using CPM but is interested in accelerating it if possible.The project has the following activities, durations (in weeks), costs, and precedence relationships:   a.How many paths are in the network? b.What is the earliest finish (EF) time for activity f? c.What is the slack in weeks for activity c? d.What is the critical path? e.What is the duration of the critical path in weeks? f.What activity should be crashed first to accelerate the project? g.What is the final duration of the fully crashed project? h.What is the total crashing cost for the project?
a.How many paths are in the network?
b.What is the earliest finish (EF) time for activity f?
c.What is the slack in weeks for activity "c"?
d.What is the critical path?
e.What is the duration of the critical path in weeks?
f.What activity should be crashed first to accelerate the project?
g.What is the final duration of the fully crashed project?
h.What is the total crashing cost for the project?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
59
A company has used PERT for a project and wants to minimize the probability of overrunning a contract deadline of 30 weeks.Three paths of concern in the PERT network have these mean durations and variances in weeks:
A company has used PERT for a project and wants to minimize the probability of overrunning a contract deadline of 30 weeks.Three paths of concern in the PERT network have these mean durations and variances in weeks:   a.What is the Z-score for path 1? b.What is the probability of path 2 overrunning the deadline?
a.What is the Z-score for path 1?
b.What is the probability of path 2 overrunning the deadline?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
60
The following network shows the activities on the circles or nodes.Time estimates are in weeks. The following network shows the activities on the circles or nodes.Time estimates are in weeks.   Complete the following table:  Complete the following table:
The following network shows the activities on the circles or nodes.Time estimates are in weeks.   Complete the following table:
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
61
You are in charge of the "advertising program" for the Boston Red Sox baseball team during their spring training in Fort Myers, Florida.You have defined the advertising program as a project with the following characteristics.The goal is to fill all stadium seats during the spring training season.
You are in charge of the advertising program for the Boston Red Sox baseball team during their spring training in Fort Myers, Florida.You have defined the advertising program as a project with the following characteristics.The goal is to fill all stadium seats during the spring training season.   a.What is the earliest completion time for this project? b.What is the largest amount of slack that any activity has in this project? c.If activity C is delayed three weeks, what is the revised earliest project completion time? d.For the original CPM problem, what is the minimum number of activities that would have to be crashed in order to reduce the project's earliest completion time by two weeks assuming all activity crash costs per week are the same and all activities can be crashed?
a.What is the earliest completion time for this project?
b.What is the largest amount of slack that any activity has in this project?
c.If activity C is delayed three weeks, what is the revised earliest project completion time?
d.For the original CPM problem, what is the minimum number of activities that would have to be crashed in order to reduce the project's earliest completion time by two weeks assuming all activity crash costs per week are the same and all activities can be crashed?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
62
A manufacturing company wants to accelerate a project it has underway for a new product in order to beat their competitors to market.They used CPM to develop the project which has the following activities, durations (in weeks), costs (in dollars), and precedence relationships:
A manufacturing company wants to accelerate a project it has underway for a new product in order to beat their competitors to market.They used CPM to develop the project which has the following activities, durations (in weeks), costs (in dollars), and precedence relationships:   a.How many paths are in the network? b.What is the latest finish (LF) time for activity g? c.What is the slack in weeks for activity c? d.What is the critical path for this project? e.What is the duration of the critical path in weeks? f.What activity should be crashed first in order to accelerate the project? g.What is the final project duration in weeks assuming it is crashed as far as possible? h.What is total cost to crash the project as far as possible?
a.How many paths are in the network?
b.What is the latest finish (LF) time for activity g?
c.What is the slack in weeks for activity c?
d.What is the critical path for this project?
e.What is the duration of the critical path in weeks?
f.What activity should be crashed first in order to accelerate the project?
g.What is the final project duration in weeks assuming it is crashed as far as possible?
h.What is total cost to crash the project as far as possible?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
63
You are responsible for managing an advertising and promotion project with the following activities (times are given in weeks).
You are responsible for managing an advertising and promotion project with the following activities (times are given in weeks).   a.What is the critical path and expected completion time for this project? b.Which activity has the largest slack, and how large is that slack? c.What is the probability that the project will be completed within 16 weeks? d.If the expected time (not the most likely time) for activity B is changed to 18 weeks from 11 weeks, by how many weeks will the project's expected completion time increase?
a.What is the critical path and expected completion time for this project?
b.Which activity has the largest slack, and how large is that slack?
c.What is the probability that the project will be completed within 16 weeks?
d.If the expected time (not the most likely time) for activity B is changed to 18 weeks from 11 weeks, by how many weeks will the project's expected completion time increase?
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
Unlock Deck
k this deck
locked card icon
Unlock Deck
Unlock for access to all 63 flashcards in this deck.
