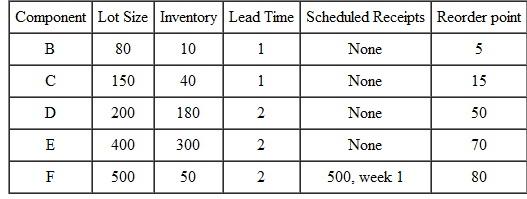

Following is the information about Polybob model A that Ken suggested as a representative model to use for the analysis:
The following are the master schedule production lots for Model A:
Complete 50 units, week 3
Complete 50 units, week 5
Complete 60 units, week 7
Complete 60 units, week 9
Complete 50 units, week 11
Upon seeing this information, Jim stated, "Look at how regular our production schedule is for this model. The reorder points will more than cover requirements, and none have lead times that make it tough to respond. This analysis should show that all the work I did on EOQ and reorder points was right, and the real problem lies with those sales and finance people who don't understand our production needs."
Suppose that the design engineer advises that he has a new design for component F. It won't be ready until sometime after week 2, but he wants you to give a date for the first supplier shipment to come in, and you should be ready to tell the supplier how many to ship. Since the change is transparent to the customer, the design engineer advises you to go ahead and use up any existing material of the model. How will MRP help you to deal with this issue?

Complete 50 units, week 3
Complete 50 units, week 5
Complete 60 units, week 7
Complete 60 units, week 9
Complete 50 units, week 11
Upon seeing this information, Jim stated, "Look at how regular our production schedule is for this model. The reorder points will more than cover requirements, and none have lead times that make it tough to respond. This analysis should show that all the work I did on EOQ and reorder points was right, and the real problem lies with those sales and finance people who don't understand our production needs."
Suppose that the design engineer advises that he has a new design for component F. It won't be ready until sometime after week 2, but he wants you to give a date for the first supplier shipment to come in, and you should be ready to tell the supplier how many to ship. Since the change is transparent to the customer, the design engineer advises you to go ahead and use up any existing material of the model. How will MRP help you to deal with this issue?
Explanation
Company AP was facing serious production...
Introduction to Materials Management 8th Edition by Steve Chapman ,Tony Arnold ,Ann Gatewood ,Lloyd Clive
Why don’t you like this exercise?
Other Minimum 8 character and maximum 255 character
Character 255
