A resource loading chart displays:

Free
(Multiple Choice)
4.9/5
(39)
Correct Answer:
Verified

B

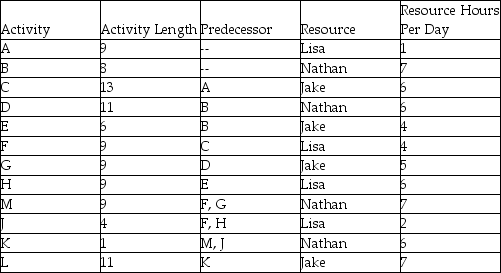

Create a resource loading chart for the project described by this table and then adjust activities by splitting them or delaying them in order to meet the resource constraints of 8 hours of work per day.Show your new resource loading chart,indicating which activities have been adjusted.What is the change in project completion dates? Create a resource loading chart for the project described by this table and then adjust activities by splitting them or delaying them in order to meet the resource constraints of 8 hours of work per day.Show your new resource loading chart,indicating which activities have been adjusted.What is the change in project completion dates?

Free
(Essay)
4.9/5
(36)
Correct Answer:
Verified

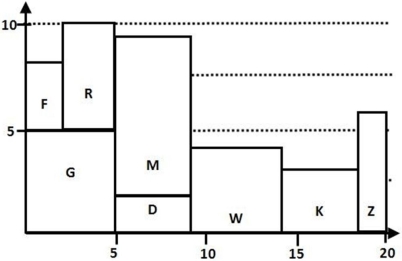

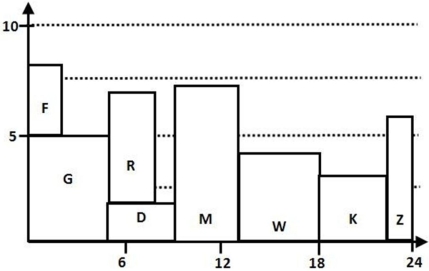

The initial resource loading chart is below;project completion time is 20 days but the combination of activities R and G and activities M and D exceed the 8-hour-per-day threshold. The initial resource loading chart is below;project completion time is 20 days but the combination of activities R and G and activities M and D exceed the 8-hour-per-day threshold.   Activities R and M both have 5 days of slack;if activity R is delayed until day 5,it will begin then and be completed on day 8.M must be delayed until D is completed,which will then delay the project's completion by 4 days.  Activities R and M both have 5 days of slack;if activity R is delayed until day 5,it will begin then and be completed on day 8.M must be delayed until D is completed,which will then delay the project's completion by 4 days. The initial resource loading chart is below;project completion time is 20 days but the combination of activities R and G and activities M and D exceed the 8-hour-per-day threshold.   Activities R and M both have 5 days of slack;if activity R is delayed until day 5,it will begin then and be completed on day 8.M must be delayed until D is completed,which will then delay the project's completion by 4 days.

What are any four heuristics for prioritizing resource allocation to activities? Why would a project manager choose one above another?

Free
(Essay)
4.8/5
(38)
Correct Answer:
Verified

The decision rules for prioritizing resource allocation discussed in the text are:
activities with the smallest amount of slack,
activities with the smallest duration,
activities with the lowest identification number,
activities with the most successor tasks,
activities requiring the most resources.
These decision rules can be applied more easily than searching for an optimal or near optimal solution given the complexity of a typical resource management problem.The first rule,prioritizing activities with the smallest slack has some support for resulting in the smallest overall schedule slippage.The fourth rule allows for completing the greatest number of tasks once the activity in question has been completed.There may be any number of individual circumstances why one rule is more appealing than another.

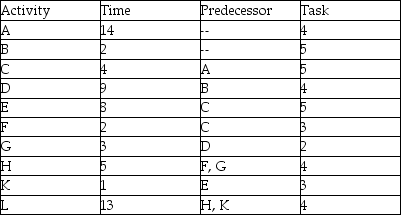

Use the project described in the table to determine the total resources required for this project on day 10 if a worker is expected to devote half-time (four hours per day)to this project.Assume that the project work is conducted on a 5-day-per-week basis. Use the project described in the table to determine the total resources required for this project on day 10 if a worker is expected to devote half-time (four hours per day)to this project.Assume that the project work is conducted on a 5-day-per-week basis.

(Multiple Choice)
4.9/5
(23)

Use the project described in the table to determine the total resources required for this project if a worker is expected to devote half-time (four hours per day)to this project. Use the project described in the table to determine the total resources required for this project if a worker is expected to devote half-time (four hours per day)to this project.

(Multiple Choice)
4.9/5
(42)

What is mathematical programming,how can it be applied to resource decisions,and what are the advantages and disadvantages of doing so?

(Essay)
4.8/5
(28)

The project described in the table uses the same resource for activities A,B,C,and D.Which activity gets first use of this resource if we assign the resource based on the activity with the smallest amount of slack? The project described in the table uses the same resource for activities A,B,C,and D.Which activity gets first use of this resource if we assign the resource based on the activity with the smallest amount of slack?

(Multiple Choice)
4.9/5
(33)

Operation Main Strike required several tons of dynamite and a significant amount of manual labor.Max Zorin knew he had a(n)________-constrained project and also had James Bond to contend with.

(Essay)
4.8/5
(33)

What are the three types of constraints that projects face;provide examples and suggest ways to address these constraints?

(Essay)
4.7/5
(34)

A resource loading table is created through identifying the project activities and the resources required for completion and applying this information to the project schedule baseline.

(True/False)
4.8/5
(32)

All that is needed to create a resource loading calendar is the work breakdown structure and the activity network.

(True/False)
4.9/5
(31)

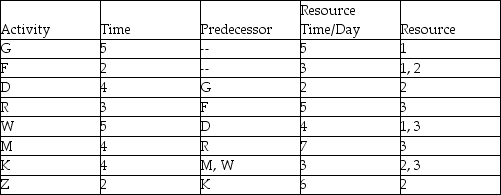

What resources have been initially over-allocated in the project described by the table? Assume that all activities will begin at their early start times and require the number of hours per day indicated in the table.Each worker is available for 8 hours per day.Do not level this project. What resources have been initially over-allocated in the project described by the table? Assume that all activities will begin at their early start times and require the number of hours per day indicated in the table.Each worker is available for 8 hours per day.Do not level this project.

(Essay)
4.9/5
(34)

The One Shovel Construction Company is hired by the City of Edmond to lay sewer pipe from the east end of town to the west end of town.While the crew would like to begin at both ends simultaneously and have a dramatic ceremony when both ends meet,they find themselves with a bit of a:

(Multiple Choice)
4.8/5
(31)

Use the information in the table and assume that a worker is expected to devote half-time (four hours per day)to this project with work taking place on a 5-day-per-week basis.If the project manager is told that the total number of hours per week cannot exceed 48,what is the first week that some resource leveling must occur? Use the information in the table and assume that a worker is expected to devote half-time (four hours per day)to this project with work taking place on a 5-day-per-week basis.If the project manager is told that the total number of hours per week cannot exceed 48,what is the first week that some resource leveling must occur?

(Multiple Choice)
4.8/5
(29)

The concept of ________ refers to the amounts of individual resources that a schedule requires during specific time periods.

(Essay)
4.8/5
(29)

The amounts of individual resources that a schedule requires during specific time periods is referred to as the resource's:

(Multiple Choice)
4.8/5
(26)

Use the information in the table and assume that a worker is expected to devote half-time (four hours per day)to this project with work taking place on a 5-day-per-week basis.What is the total resource requirement for the project? Use the information in the table and assume that a worker is expected to devote half-time (four hours per day)to this project with work taking place on a 5-day-per-week basis.What is the total resource requirement for the project?

(Multiple Choice)
4.9/5
(41)

The Minimum Late Finish Time rule stipulates that:

(Multiple Choice)
4.7/5
(27)

Use the project described in the table to determine the total resources required for this project during week 1 if a worker is expected to devote half-time (four hours per day)to this project.Assume that the project work is conducted on a 5-day-per-week basis. Use the project described in the table to determine the total resources required for this project during week 1 if a worker is expected to devote half-time (four hours per day)to this project.Assume that the project work is conducted on a 5-day-per-week basis.

(Multiple Choice)
4.8/5
(40)

Create a resource loading chart using early start times for the project described by this table. Create a resource loading chart using early start times for the project described by this table.

(Essay)
4.8/5
(32)
Showing 1 - 20 of 93
